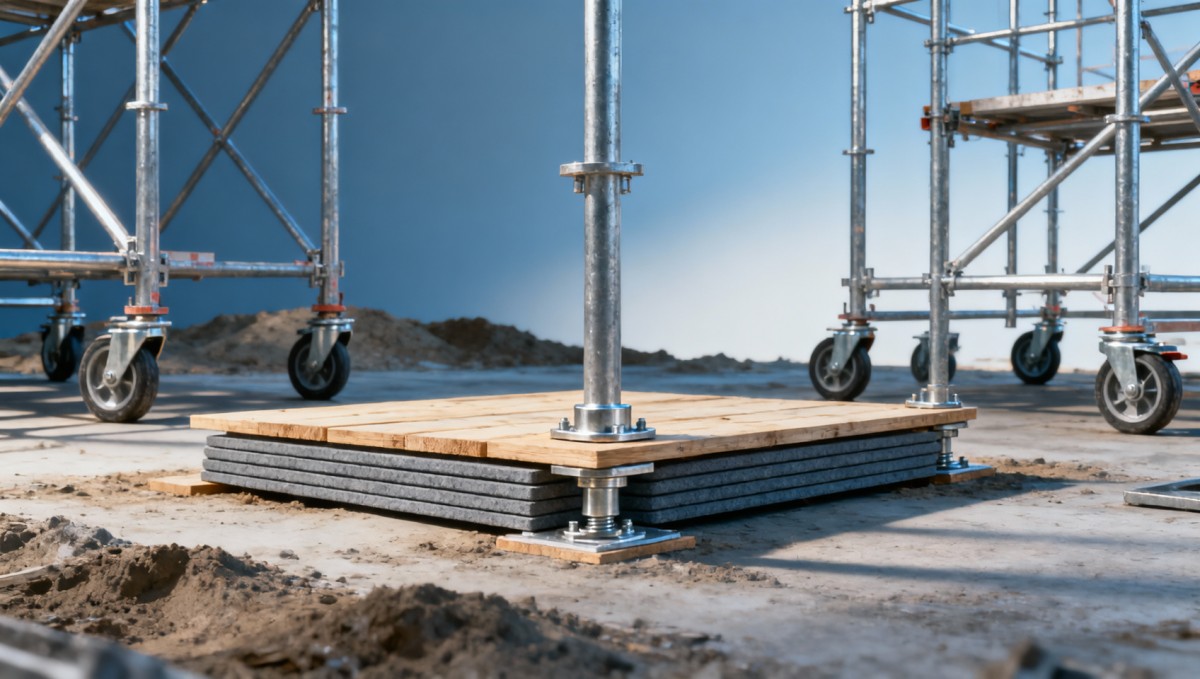

On uneven ground, even high-quality scaffolding base plates wholesale solutions can fail when load transfer, soil bearing, and setup practices are misunderstood. For buyers comparing frame scaffolding system bulk, kwikstage scaffolding parts, and scaffolding caster wheels wholesale, this issue directly affects safety, cost, and project continuity. This article explains why failures happen, what warning signs to assess, and how related systems like climbing formwork systems influence overall site stability.
For tourism developers, resort contractors, modular hospitality installers, and procurement teams working on sloped, reclaimed, coastal, or partially stabilized sites, the risk is especially relevant. Temporary access structures, façade work platforms, utility installation decks, and formwork support often sit on terrain that looks acceptable at first glance but behaves very differently under live load after rain, vibration, or repeated material handling.
A failed base plate is rarely an isolated hardware issue. In most cases, it reflects a chain of preventable errors: undersized bearing area, poor ground preparation, mismatched jacks, improper use of caster wheels, or a scaffold layout that concentrates force in a few legs. For B2B buyers, the right question is not only whether the steel component meets specification, but whether the full support condition has been evaluated before purchase and deployment.

A scaffolding base plate is designed to spread vertical load from a standard, jack, or frame leg into the supporting surface. On level, compacted ground, that transfer is predictable. On uneven ground, however, the contact stress is rarely uniform. A 3 mm to 8 mm difference in support level across adjacent legs can redirect load unexpectedly, causing one or two points to carry a disproportionate share of the structure.
This matters because scaffold stability depends on system behavior, not component strength in isolation. A steel base plate with sufficient thickness may still punch into soft soil if the bearing area is too small. In practice, edge settlement, voids under sole boards, and moisture-softened fill can reduce effective support capacity by 20% to 50% compared with dry, compacted conditions.
Tourism and hospitality construction often adds complexity. Glamping platforms, resort landscaping, service corridors, and outdoor attractions are frequently built on graded hillsides, backfilled zones, or surfaces disturbed by drainage work. Even when the superstructure is light, temporary access scaffolds can see repeated live loads from workers, cladding, glazing panels, piping bundles, and tools over 2 to 8 weeks.
The most common misunderstanding is assuming that thicker metal solves everything. In reality, failures often begin below the plate. If the ground cannot support the transferred pressure, or if one leg settles 10 mm more than the next, the scaffold frame can rack, braces can lose intended geometry, and caster-equipped towers may drift or lock unevenly. That is why procurement review should consider soil condition, sole plate dimensions, adjustability range, and system compatibility together.
When uneven ground causes failure, the pattern usually falls into a small number of repeatable mechanisms. Buyers and site supervisors should recognize these patterns early because each one points to a different corrective action.
Each mechanism can appear on the same site. On mixed surfaces such as compacted gravel beside concrete apron edges, one side may remain stable while the other settles gradually. That is why inspection intervals matter. On changing ground, checks at installation, after the first heavy load cycle, and after rainfall within 24 hours are more useful than a single acceptance check.
For purchasing teams, base plate evaluation should start with load path mapping rather than catalog comparison alone. The key procurement question is simple: what load reaches each leg, through what adjustment device, and onto what surface? If those three variables are unclear, a low unit price on scaffolding base plates wholesale supply can create a much higher total project cost through rework, downtime, or rejected site safety inspections.
A practical review covers at least 4 dimensions: plate size, steel thickness, jack compatibility, and recommended support media such as timber sole boards or steel spreaders. For many temporary works setups, a larger bearing footprint produces greater field value than a small increase in plate thickness. Procurement teams should also confirm whether the supplier’s dimensions match the intended frame scaffolding system bulk package or kwikstage scaffolding parts already specified.
On sloped or mixed ground, adjustability matters. A screw jack that is extended too far can become the weak link even when the base plate itself is adequate. As a rule of thumb in many field setups, keeping jack extension within the supplier’s advised working band and avoiding extreme correction at a single leg provides better stiffness than trying to “solve” grade differences with hardware alone.
The table below summarizes the main evaluation factors that procurement and technical teams should review before ordering. It is especially useful when comparing suppliers that offer similar-looking products but very different field performance expectations.
| Evaluation factor | What to confirm | Why it affects failure risk |
|---|---|---|
| Base plate footprint | Length, width, and contact area with sole board or slab | Small footprints increase bearing pressure and sinking risk on soft or wet ground |
| Material thickness and fabrication | Plate thickness, weld continuity, flatness, and deformation tolerance | Poor flatness or weak welds create partial contact and unstable load transfer |
| Jack and standard compatibility | Thread size, stem diameter, fit with frame or ringlock interface | Mismatch can cause eccentric loading, wobble, or unsafe improvisation on site |
| Recommended ground preparation | Required sole boards, compaction level, drainage control, and reinspection interval | Even strong components fail when ground condition assumptions are wrong |
The main conclusion is that buyers should request support-condition guidance with the product, not just dimensional drawings. A supplier that can explain where the hardware works, where it should not be used, and when spreader boards are mandatory is often more valuable than one that competes on piece price alone.
For distributed tourism projects with multiple small structures, this checklist can be built into RFQ documentation. That reduces ambiguity for dealers, distributors, and procurement reviewers who must compare offers across more than one product family.
Early warning signs usually appear before a visible failure. The problem is that many teams notice them but treat them as routine adjustment issues. For projects with schedule pressure, especially hotel fit-outs or attraction maintenance windows, a small lean or slight settlement may be tolerated until it becomes a structural concern. That is an expensive habit.
A practical site rule is to distinguish between static irregularity and progressive movement. If a base plate starts out firm and remains unchanged, the issue may be manageable with correct leveling and sole board support. If the plate continues to indent, rotate, or lose full contact over 12 to 48 hours, the support condition is degrading and the scaffold should be reassessed immediately.
Particular caution is needed where scaffolding caster wheels wholesale products are combined with temporary ramps, paving joints, utility trenches, or decorative outdoor surfaces common in hospitality developments. Wheels can hide load concentration because movement shifts force dynamically. A tower that feels acceptable when empty may become unstable once tools, façade materials, or mechanical equipment are loaded above the base.
The following table lists common field indicators and the action they typically require. It can serve as a quick reference for site managers, commercial evaluators, and distributor technical teams supporting end users.
| Observed sign | Likely cause | Recommended action |
|---|---|---|
| Base plate leaves visible imprint after rain | Reduced soil bearing capacity due to saturation | Unload area, improve drainage, add proper sole boards, and re-level structure |
| One leg requires repeated jack adjustment | Ongoing settlement or hidden void below board | Lift and inspect support base instead of continuing adjustment |
| Caster wheel locks engage unevenly | Surface is not level, frame is twisted, or wheel loading is inconsistent | Relocate to level slab or redesign access method; do not rely on wheel locks alone |
| Diagonal braces no longer align cleanly | Differential settlement between adjacent legs | Stop loading, check plumb, and reset support condition before use continues |
The most important takeaway is speed of response. Once differential settlement starts, it rarely corrects itself. On fast-track sites, delaying intervention by even 1 shift can turn a simple base correction into partial dismantling, material damage, or a safety stand-down that affects multiple trades.
These triggers are especially relevant in hospitality projects where decorative finishes conceal service trenches, landscape fill, or recently compacted utility corridors. Surface appearance is not a reliable indicator of support quality.
Scaffold base problems become more complex when they interact with neighboring temporary works. One important example is climbing formwork systems. Although climbing formwork and independent scaffolding serve different functions, they often share the same construction zone, sequence, and access routes. That means one system can affect the ground condition, loading pattern, or movement constraints of the other.
For instance, repeated material staging near a formwork line can compact one strip of ground while leaving adjacent zones softer. Concrete washout, water runoff, and plant movement can also alter support conditions around temporary access scaffold legs. If procurement and site planning treat these systems separately, hidden interaction risk increases. For projects with façades, retaining structures, or elevated service cores, coordination should happen before delivery, not after erection.
There is also a sequencing issue. A climbing formwork system may reduce the need for some external scaffold areas, but it can increase localized traffic and temporary storage in others. As a result, the safest base plate choice is not always the lightest or cheapest option. In mixed-system zones, buyers should assess not only static support but also temporary disturbance over a 1-week to 4-week construction window.
The relationship is easier to manage when teams define support interfaces in advance. That includes traffic corridors, restricted wheel movement zones, drainage routes, and inspection ownership. For distributors and procurement officers, suppliers that can provide coordination guidance across frame systems, kwikstage scaffolding parts, jacks, and access components reduce downstream ambiguity.
Separate pedestrian routes, wheel routes, and material staging zones wherever possible. If the same strip of ground must support both scaffold access and frequent plant movement, additional spreader measures or periodic reinspection should be planned from day 1.
Many failures occur after otherwise acceptable support softens due to runoff. Even a moderate slope can channel water directly under sole boards. Temporary drainage, gravel topping, or raised support details may provide more value than upgrading plate thickness alone.
Clarify which team signs off mobile towers, fixed scaffolds, and formwork access interfaces. A simple 3-party review between installer, main contractor, and procurement representative can prevent incompatible field substitutions.
The strongest commercial strategy is to buy for the actual site condition, not the idealized drawing. On paper, many scaffolding base plates wholesale offers look interchangeable. In the field, performance changes significantly depending on whether the project is on firm slab, compacted crushed stone, landscaped fill, or variable backfill near hospitality infrastructure. A disciplined purchasing approach combines hardware selection with deployment controls.
Start by dividing projects into at least 3 ground categories: stable hard surface, prepared granular base, and uncertain or moisture-sensitive ground. Then define what support accessory is mandatory in each case. This creates cleaner RFQs and makes distributor quotations easier to compare. It also helps commercial evaluators estimate the real landed cost, including boards, inspections, replacement rate, and delay exposure.
For buyers handling frame scaffolding system bulk and kwikstage scaffolding parts across multiple sites, standardization helps. Using a limited range of compatible base plates, jacks, and support boards can simplify training and reduce field improvisation. However, standardization should not eliminate escalation rules. If site slope, settlement history, or water exposure exceeds predefined thresholds, a higher-control setup should be required.
The selection matrix below can support specification decisions during sourcing, especially for tourism projects with varied outdoor environments.
| Site condition | Preferred support approach | Buyer note |
|---|---|---|
| Level concrete slab with low moisture exposure | Standard base plate or compatible base jack with verified contact | Best environment for mobile units, but slab joints and edge drops still require review |
| Compacted granular base outdoors | Base plate plus full-bearing sole board and scheduled reinspection | Suitable for many resort and glamping builds if drainage is controlled |
| Backfilled, sloped, or moisture-sensitive ground | Engineered spreader arrangement, restricted loading, and closer inspection cycle | Do not rely on base plate size alone; require technical review before deployment |
| Mobile tower route with caster wheels | Continuous level travel path, wheel load check, and route control | Uneven paving can make an otherwise adequate wheel specification unsafe in use |
The matrix shows a simple pattern: as ground uncertainty increases, the decision shifts from hardware-only purchasing to system-based risk control. That is the point where technical benchmarking adds value, especially for developers and operators who must defend procurement choices to safety, engineering, and finance teams.
If the support surface is not hard slab, or if moisture, slope, or fill variability is present, a larger bearing area or spreader arrangement should be reviewed. A small settlement over the first 24 to 72 hours is already a signal that support assumptions may be too optimistic.
Only where the route is consistently level, hard, and free from joints, covers, and soft edges. Decorative paving and landscape interfaces often create hidden transitions that make mobile towers less stable than they appear during initial setup.
At minimum, dimensional details, compatibility notes, recommended use limits, and guidance on support conditions. Clear documentation shortens technical review and reduces disputes when products are installed across varied project environments.
Scaffolding base plates fail on uneven ground not because the issue is rare, but because it is underestimated. The root causes are usually predictable: poor load distribution, weak bearing conditions, overreliance on adjustment, and weak coordination with adjacent systems such as climbing formwork. For buyers, the safest and most cost-effective decision is to evaluate hardware together with ground condition, movement pattern, and inspection plan.
TerraVista Metrics supports data-driven technical evaluation for tourism and hospitality infrastructure supply chains, helping procurement teams move beyond surface-level product claims toward measurable field suitability. If you need help comparing scaffolding base plates wholesale options, frame scaffolding system bulk packages, kwikstage scaffolding parts, or mobile access configurations for challenging sites, contact us to discuss a tailored assessment, product benchmarking framework, or project-specific sourcing strategy.
